Page 80 - Shelter-October-2022
P. 80

CASE STUDIES


              residents claimed that before   infrastructure  amenities  that   scheme. The parameters were
              the    redevelopment,     the   in  turn have  raised the  level   predicated on the notion of
              unclean   and    substandard    of living overall, produced     different attributes and other
              living          environments    a safe neighbourhood, and       criteria needed for grading.
              contributed to the spread of    promoted social cohesiveness.   The overall analysis was
              disease, increasing their health                                based on the primary survey
              care  expenses,  demoralising   QUALITY OF LIFE                 observations.   The    study
              or preventing them from         A    qualitative   technique    measured the quality of life
              working, and compromising       was    used   to   determine    in the in-situ resettlement
              the community’s well-being.     the      effectiveness     of   community based on five
              The implementation of the       specific   scheme    features   crucial   parameters    (F5):
              programme, on the other         in determining the quality      household        satisfaction;
              hand,  was  intended  to  offer   of life of beneficiaries after   stakeholder   satisfaction;
              better social and physical      the implementation  of the      housing    operating   costs;

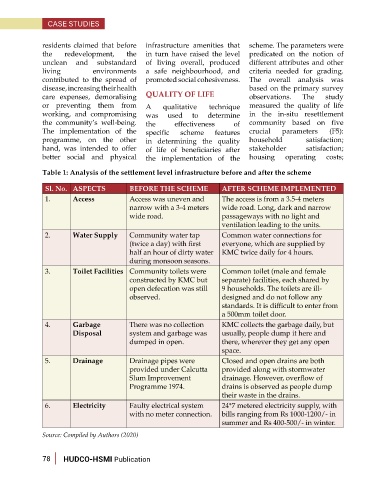

              Table 1: Analysis of the settlement level infrastructure before and after the scheme

               Sl. No. ASPECTS           BEFORE THE SCHEME           AFTER SCHEME IMPLEMENTED
               1.      Access            Access was uneven and       The access is from a 3.5-4 meters
                                         narrow with a 3-4 meters    wide road. Long, dark and narrow
                                         wide road.                  passageways with no light and
                                                                     ventilation leading to the units.
               2.      Water Supply      Community water tap         Common water connections for
                                         (twice a day) with first    everyone, which are supplied by
                                         half an hour of dirty water  KMC twice daily for 4 hours.
                                         during monsoon seasons.
               3.      Toilet Facilities Community toilets were      Common toilet (male and female
                                         constructed by KMC but      separate) facilities, each shared by
                                         open defecation was still   9 households. The toilets are ill-
                                         observed.                   designed and do not follow any
                                                                     standards. It is difficult to enter from
                                                                     a 500mm toilet door.
               4.      Garbage           There was no collection     KMC collects the garbage daily, but
                       Disposal          system and garbage was      usually, people dump it here and
                                         dumped in open.             there, wherever they get any open
                                                                     space.
               5.      Drainage          Drainage pipes were         Closed and open drains are both
                                         provided under Calcutta     provided along with stormwater
                                         Slum Improvement            drainage. However, overflow of
                                         Programme 1974.             drains is observed as people dump
                                                                     their waste in the drains.
               6.      Electricity       Faulty electrical system    24*7 metered electricity supply, with
                                         with no meter connection.   bills ranging from Rs 1000-1200/- in
                                                                     summer and Rs 400-500/- in winter.

              Source: Compiled by Authors (2020)


              78     HUDCO-HSMI Publication
